Article

Portfolio management with OGSM: what to start, what to improve, what to stop

Look closely at the action list of most OGSMs and you will find things that are not really actions.

“Replace the core system.” “Set up the German subsidiary.” “Migrate to the new platform.” These are programmes and projects. They run for quarters rather than weeks, they cost real money, they need people from three departments, and they will quietly absorb whatever capacity you give them.

An organization that treats them as ordinary actions ends up with twenty of them running at forty percent effort. Everything is in progress. Nothing finishes. And because nothing has formally been stopped, nobody has to admit that the list is longer than the organization.

Portfolio management is the discipline of making those choices on purpose: what to start, what to improve, and what to stop.

Three phases, two decision points

The whole thing is a funnel with two gates in it. Initiatives come in at the wide end, and at each gate a session decides which of them go on.

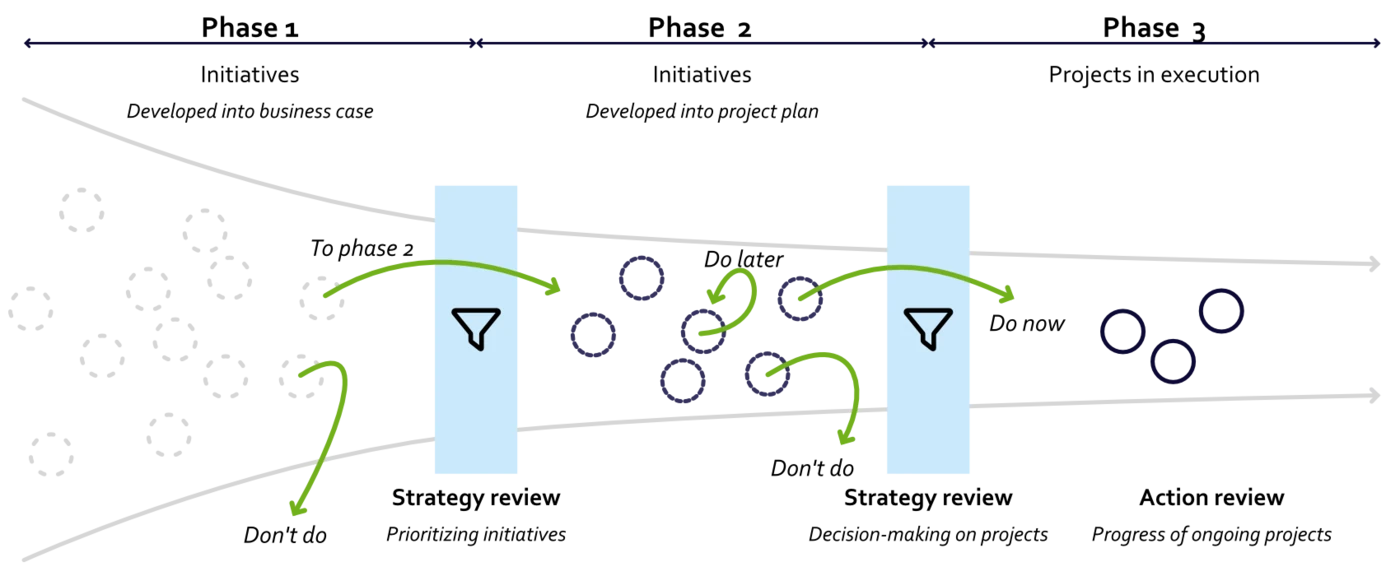

Portfolio management as a funnel in three phases: initiatives developed into a business case, then into project plans, then projects in execution, with a strategy review deciding at each of the two narrowing points and an action review tracking the projects that are running
Two gates, both of them strategy reviews. The first prioritises initiatives, the second decides which projects actually start.

Note where the gates are. They are not extra meetings. They are the strategy review you already hold every quarter, doing one more piece of work. That matters more than it sounds: a portfolio process that needs its own governance layer is a portfolio process that gets skipped by March.

Phase 1: inventory the initiatives

The first phase has one job, and it is not deciding. It is finding out what is actually on the table.

Collect every initiative anyone is proposing, including the ones already quietly under way, and work each one up far enough to be comparable with the others. That means a short project initiation document or business case covering:

Then score each initiative on value and effort using the Fibonacci scale: 1, 2, 3, 5, 8, 13, 21. The gaps widen as the numbers grow, which is honest about how well anyone can estimate. A team can score twenty initiatives in an hour this way, and the result is accurate enough to sort them even though no individual number is defensible.

Plot the two against each other and the shape of the portfolio becomes visible immediately. High value, low effort is where you start. High effort, low value is the quadrant everyone recognises and nobody wants to name out loud.

Initiatives plotted on a value and effort matrix in OGSM.online, split into quick wins, major projects, small improvements and reconsider
Value against effort, in quadrants. The conversation this starts is the point of phase 1.

Phase 1 ends with a decision, and it has to be a real one: which initiatives go through to phase 2, and which ones you are not going to do. Not “later”. Not “parked”. Not done. An initiative that never gets a no keeps consuming attention, and attention is the resource you are actually short of.

Phase 2: develop the plans

The initiatives that survived get worked up properly. This is where a promising idea becomes something you could hold someone to.

A project of any size deserves its own OGSM. Same four blocks: an objective saying what this project is for, goals that make it measurable, the strategic choices about how to run it, and measures split into the KPIs you steer by and the actions the team takes. It is the same model as the plan above it, which is what lets a project stay connected to the strategy it came from instead of drifting into its own universe.

Record the budget in both currencies: money and time. Time is the one that gets left out and the one that actually binds. Two projects can both be affordable and still be impossible together, because they need the same four people in the same quarter.

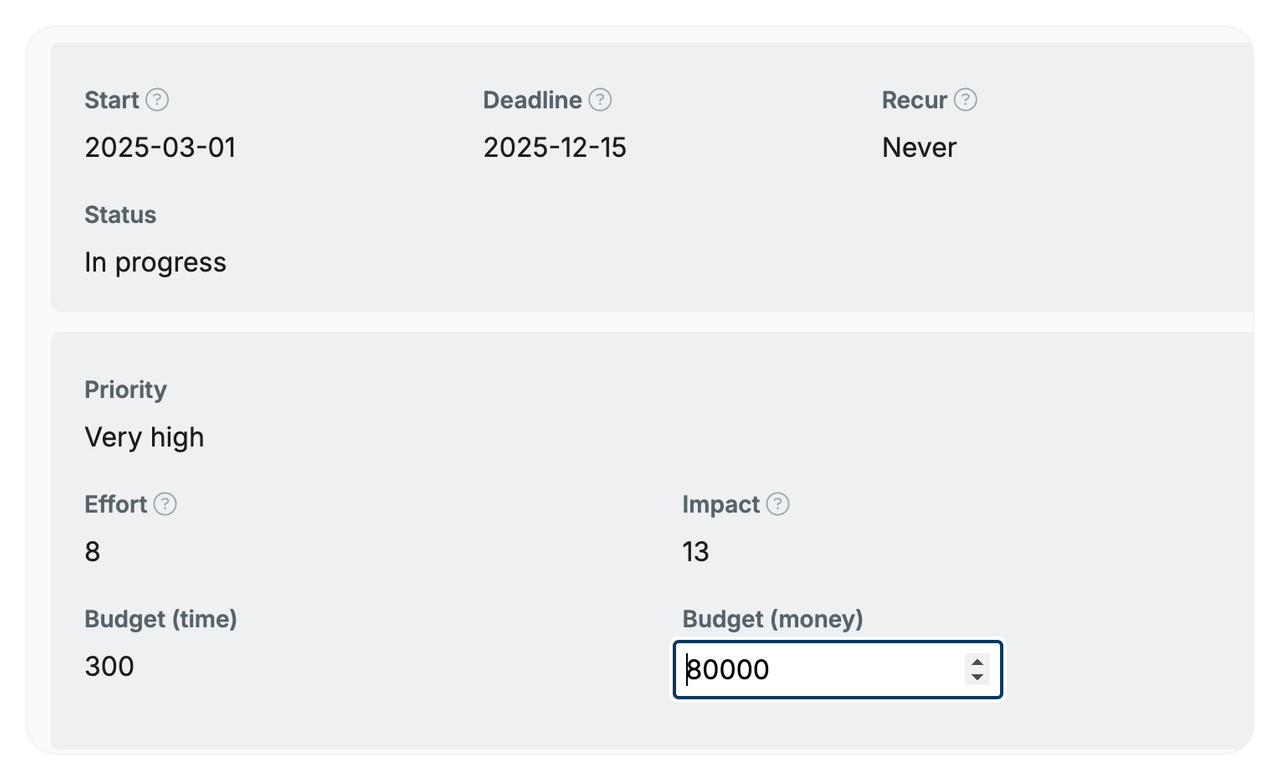

The business case of a project in OGSM.online, showing priority, effort, impact and budget in both time and money
Budget in time as well as money. Capacity is what usually decides whether two projects can run at once.

The second gate is where the start decisions are made, and it needs a weighting framework rather than a debate. Ours has four criteria and yours can differ, but write them down before you look at the projects:

Three outcomes come out of this session: do now, do later, and do not do. Keeping “do later” separate from “do not do” is what makes the framework survive contact with the people whose initiative did not make it. A no that is honest is easier to accept than a maybe that never resolves.

Phase 3: execute and steer

Approved projects run in the normal rhythm, because the rhythm is already there.

Monthly, the action review. Owners report before the session: progress, a green, amber or red assessment, and a sentence on what they need. The session spends its hour on the reds and the ambers, which is the only part that needs a room full of people.

Quarterly, the strategy review. The harder question. Is this project still worth the capacity it is using? The evidence is the KPI trend behind the strategy it serves, not the percentage complete on the project itself. A project can be ninety percent delivered and no longer worth finishing, and a quarterly cadence is how you find that out in month seven rather than month twenty.

Actions from several OGSMs on one kanban board in OGSM.online, grouped by status
Every running project on one board, whichever plan it belongs to.

Which means the portfolio is never finished. Initiatives keep arriving, projects finish, some get stopped, and capacity frees up. The two gates are permanent, not a one-off exercise you run in January.

Doing this in OGSM.online

Everything above works on paper. Here is what the platform adds once the portfolio is bigger than one page.

Collecting. An action can be marked as a programme or a project. It then carries a business case, in a layout an administrator configures to match how your organization writes them, with budget in time and money and its own OGSM underneath.

Overview. Every programme and project in the plan, in one place: as a list, on a timeline, or on the value and effort matrix. Across several plans at once on the Pro plan, which is what portfolio management usually needs.

Steering. Owners file short progress reports with a traffic light. The reports carry budget consumption alongside progress, so the strategy review has both numbers in front of it when it decides whether to continue, adjust or stop.

None of it decides anything for you. What it removes is the week of assembling the picture before you can have the conversation, which is usually why the conversation gets postponed.

Thirty days, no credit card, and the trial stops on its own.

Start your free trial

The two sessions, in full →

← All articles

Frequently asked questions

What is portfolio management?

Making deliberate choices about which initiatives to start, which to improve, and which to stop, so that capacity and budget go to the work with the best return. It is the difference between a list of everything anyone wants to do and a set of projects the organization can actually finish.

How does portfolio management relate to OGSM?

The OGSM says where you are going and which strategic choices get you there. Portfolio management decides which of the programmes and projects under those choices are worth starting, and in what order. The plan supplies the criterion: an initiative that does not serve a strategy has to justify itself some other way.

Why use the Fibonacci scale for scoring value and effort?

Because the gaps get wider as the numbers get bigger, which matches how confidently you can actually estimate. Nobody can tell an 18 from a 20, and the scale stops the conversation pretending they can. Scoring on 1, 2, 3, 5, 8, 13 and 21 takes minutes per initiative and is accurate enough to sort them.

When do you decide to stop a project?

In the quarterly strategy review, on the evidence of the progress reports and the KPI trends. A project can be stopped because it is not working, because the strategy behind it changed, or because something better needs the capacity. All three are legitimate, and none of them are failures if you write down why.

Can OGSM.online be used for portfolio management?

Yes. Actions can be marked as a programme or a project, given a business case with budget in time and money, scored on value and effort, and developed into an OGSM of their own. The overviews then show every programme and project in the plan, and the progress reports show how each is doing.
